Decide on guardrails for spending in the next program increment
02
Discovery
Document themes to help categorize and prioritize investments
03
Planning
Agree on project priorities and analyze trade-offs
04
Implementation
Organize your team's work around perceived value
05
Conclusion
Consider these questions when deciding on guardrails
Implementation
Use the following How To section to organize the work around key areas of perceived value.
Background
Program leadership wants to organize the work around key areas of perceived value, but does not have a clear concept of value defined yet
There is not a working portfolio leadership team in place that has already defined a set of epics and themes for the organization
Themes allow for organizations to have major phases / projects represented, with epics representing milestones associated with the work
How to
This procedure will show you how to create a set of epics and themes to help program leaders align their features to value.
Learn how to capture epics and themes to represent value
From the Administration menu, navigate to the Roles page
Select the Role used by the program leadership team
Click on the “+” next to “2 Portfolio” to expand the list of permissions
Confirm the toggles for the Theme row
Save <on>
Delete <on>
Work Item Mind Map <off>
Confirm the toggles for the Epic row
Add <off>
Epic Detail Report <on>
Import Epics <off>
Delete <on>
Acceptance Criteria <off>
Split <off>
Drop <off>
Work Item Mind Map <off>
Design Tab <off>
Intake Tab <off>
Benefits Tab <off>
Value Tab <off>
Time/Skill Tab <on>
Finance Tab <off>
Forecast Tab <off>
Click the Save button

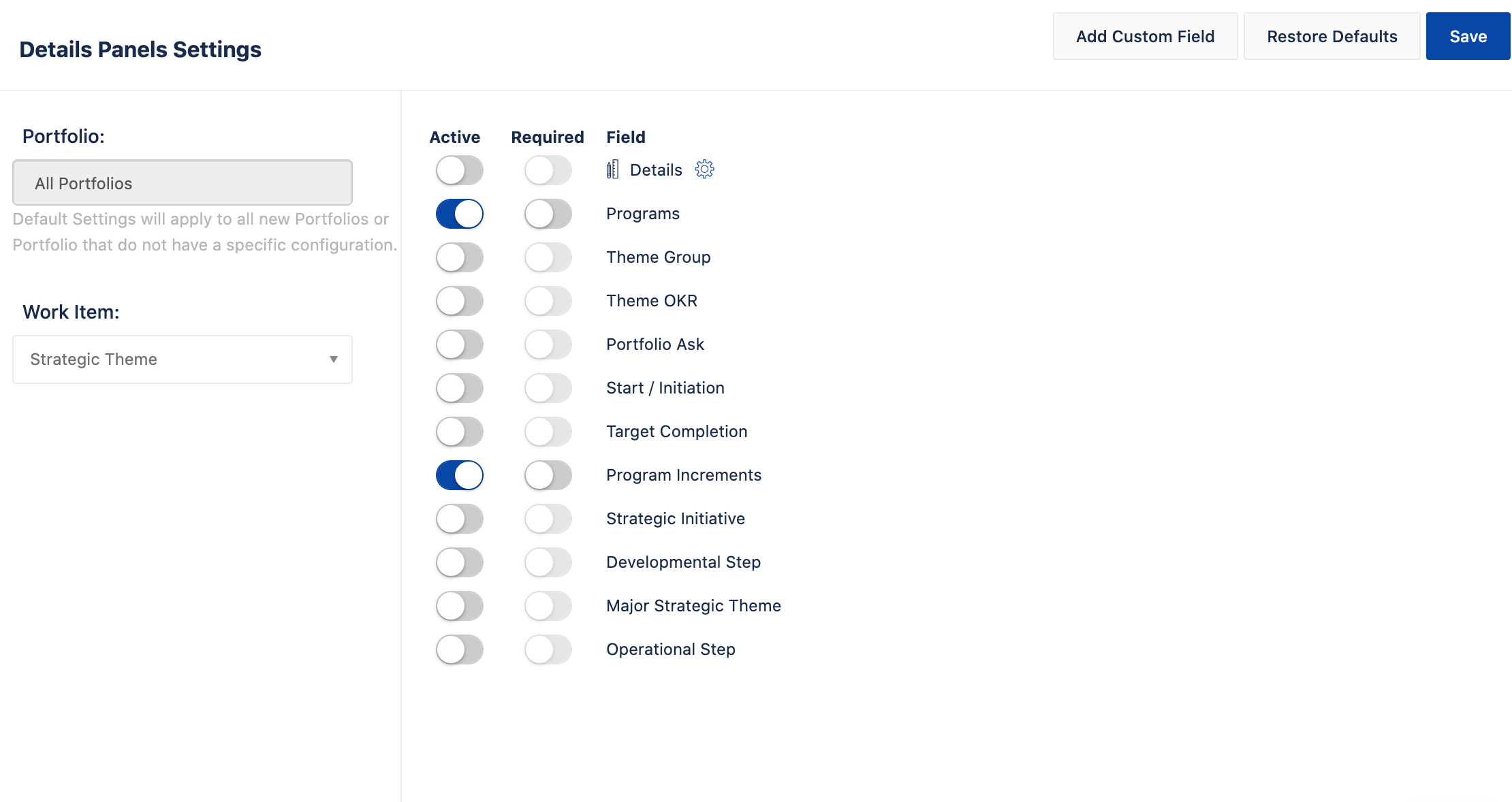

From the Administration menu, navigate to the Details Panels Settings page
Set Portfolio to <this portfolio> and select Theme
Confirm that the following field toggles are on
Programs
Program Increments
Set the following field toggles to off
Theme Group (appears only if enabled via Platform settings)
Monthly Goal
Portfolio Ask
Start / Initiation
Target Completion
Strategic Initiative
Developmental Step
Major Theme
Operational Step
Click the Save button
Set Portfolio to <this portfolio> and select Epic
Confirm that the following field toggles are on
Start/Initiation
Target Completion
Strategic Driver
Program Increment
Owner
Tags
Set the following field toggles to off
Portfolio Ask
Investment Type
Ability to Execute
Budget
Capitalized
Customers
Developmental Step
Effort SWAG
Estimate
Estimation Budget
Kano Category
Kano Certainty
Kano Complexity
MVP
Operational Step
Points
Quadrant
Story Points
Strategic Horizon
Strategic Value Score
<All fields on Benefits tab>
<All fields on Finance tab>
Click the Save button
Set Portfolio to <this portfolio> and select Feature
Confirm that the Theme field toggle is <on>
Click the Save button
From the Portfolio menu, navigate to the Themes page
Set the context configuration to Program = <this program> and PI = <next PI>
Click the Add Theme button in the upper right
Title - capture a generic kind of value (or a specific initiative) for the organization that will drive work over the next year or two
Program - set to <this program>
Program Increments - set to <next PI> and beyond, if appropriate
Description - Summarize the expected value to the business, company, product line, or customer. What is driving the work? What difference will the work make?
Active - initialize to “Yes”
Click the Save and Close button
From the Portfolio menu, navigate to the Epics page
Set the context configuration to Program = <this program> and PI = <next PI>
Click the Add Epic button in the upper right
Title - capture a generic kind of value (or a specific initiative) for the organization that will drive work as part of the theme
Description - Summarize the expected value to the business, company, product line, or customer. What is driving the work? What difference will the work make?
Type - leave as Business
Primary Program - set to <this program>
Theme - set to the theme created
Program Increments - set to <next PI> and beyond, if appropriate
Click the Save button
On the Details tab, scroll down and click “+ Full Details to expose additional fields
Start / Initiation - if there is a start data for the effort
Target Completion - if there is a targeted completion date for the effort
Strategic Driver - set to strategic driver (if using)
Click the Save button
On Time / Skills tab, scroll down to Fixed Date Milestones and enter any milestones that should show on the roadmap
Deliverable - what is the milestone
Portfolio Ask - don’t populate
Start / Initiation - when will the work on the milestone begin
Target Completion - when should the milestone be reached
Click the Save and Close button
Repeat for each specific form of value that influences the theme
Output and next steps
Confirm that a new feature can be associated with a epic, via the Parent field on the feature
